Workpackage 1 - Time series stations
Concepts and tasks:
Instrumentation in the challenging environment of the surf zone is the prerequisite for all the planned work. WP1 is in charge of ensuring the technical implementation and faces the important challenge of providing safely the technical equipment in this shallow on a long-term basis.

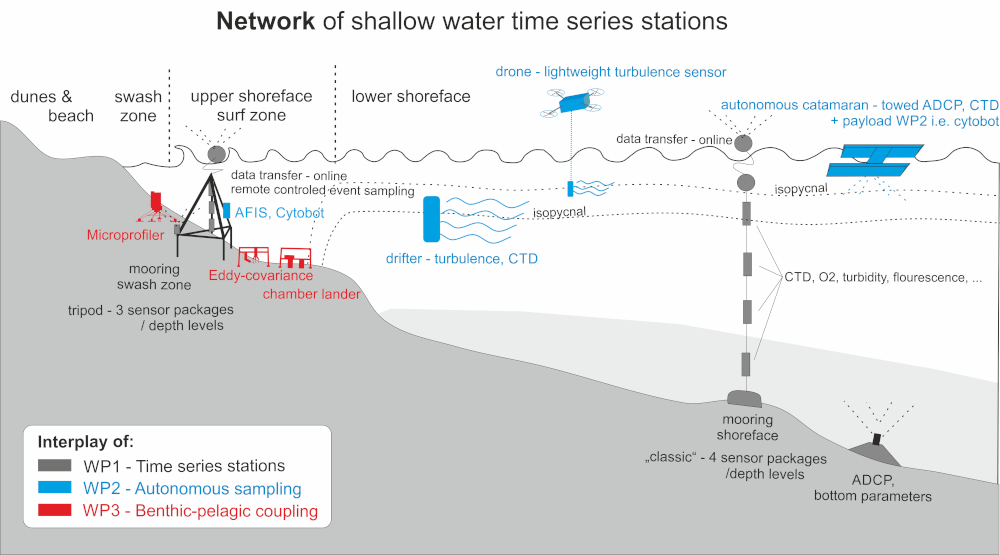

Major tasks are reliable provision of basic physical, biological, and chemical in-situ parameters which supports campaign-based sampling of the remaining work packages. Different types of coastal zones should be covered by a network of these newly developed time series stations.
Research and Development milestones:
- Jan.-March 2024 - general design finalized. Active development of "deep" mooring prototype starts
- December 2024 - "deep" mooring prototype starts its first "dry"-development

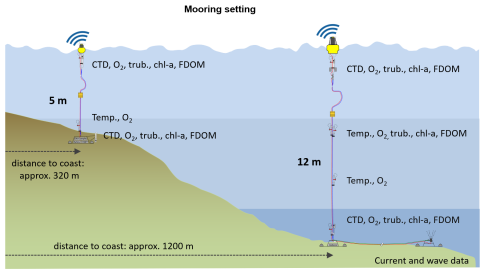

- January 2025 - "deep" mooring first in-situ deployment starts (Nienhagen, 12m water depth)
- June 2025 - "deep" mooring completes its planed six month deployment without major issues
- April 2026 - "shallow" mooring first in-situ deployment starts (Nienhagen)
- July 2026 - system of "shallow" and "deep" moorings is in operation at Nienhagen cliff section
